← 论文海报合集← Paper Notes|
World Models · Sim-to-Real · Robot Learning

Simulation Distillation: Pretraining World Models in Simulation for Rapid Real-World Adaptation

先在仿真里"蒸馏"出一个能规划的世界模型,真实世界只需做一次轻量的动力学系统辨识First "distill" a world model capable of planning inside simulation; in the real world only a single lightweight system identification of the dynamics is needed
Jacob Levy, Tyler Westenbroek, Kevin Huang, Fernando Palafox, Patrick Yin, Shayegan Omidshafiei, Dong-Ki Kim, Abhishek Gupta, David Fridovich-Keil ・ UT Austin / University of Washington / FieldAI

论文提出 SimDist(Simulation Distillation):用物理仿真器作为可规模化的、带动作标注的机器人经验来源,预训练一个可用于在线规划的世界模型;部署到真实世界时,只更新其中的 latent dynamics 模块(其余编码器、奖励模型、价值函数全部冻结迁移),把"真实世界自适应"简化为一次监督式的系统辨识,同时保留仿真中学到的长时程规划信号。在接触密集的操作任务和四足机器人越障任务上,SimDist 用极少的真实交互数据就能稳定、持续地提升性能,而对照的在线 RL 微调方法往往停滞不前甚至性能崩溃。The paper proposes SimDist (Simulation Distillation): it uses a physics simulator as a scalable source of action-labelled robot experience to pretrain a world model that supports online planning; when deploying to the real world, only the latent dynamics module inside it is updated (the encoder, reward model and value function are all transferred frozen), which reduces "real-world adaptation" to one round of supervised system identification while retaining the long-horizon planning signal learned in simulation. On contact-rich manipulation tasks and quadruped obstacle-traversal tasks, SimDist improves stably and continually with very little real interaction data, whereas the online RL finetuning methods it is compared against often stagnate or even collapse.

arXiv 2603.15759・cs.RO UR5e 操作 + Unitree Go2 四足UR5e manipulation + Unitree Go2 quadruped MPPI 在线规划MPPI online planning 📄 arXiv:2603.15759 Project page (sim-dist.github.io)
world modelsim-to-realsimulation distillationMPPI planninglatent dynamicssystem identificationrobot manipulationquadruped locomotion

01 Motivation

机器人在新环境中往往只有有限的、质量参差不齐的交互数据可用——既有示教,也有失败尝试、探索性动作和旧策略的 rollout。论文指出:"Robot learning requires adaptation methods that improve reliably from limited, mixed-quality interaction data." 这一挑战在长时程、接触密集(contact-rich)的任务中尤为突出,此时端到端策略微调(end-to-end policy finetuning)"remains inefficient and brittle"。In a new environment a robot usually has only limited, mixed-quality interaction data available — demonstrations, but also failed attempts, exploratory actions and rollouts of older policies. The paper notes: "Robot learning requires adaptation methods that improve reliably from limited, mixed-quality interaction data." This challenge is especially acute in long-horizon, contact-rich tasks, where end-to-end policy finetuning "remains inefficient and brittle".

世界模型(world model)被认为是更合适的抽象:"World models offer a compelling alternative: by predicting the outcomes of candidate action sequences, they enable online planning through counterfactual reasoning." 但直接在真实世界里训练带动作条件的机器人世界模型,需要规模上不现实的多样化数据——"training action-conditioned robotic world models directly in the real world requires diverse data at impractical scale."The world model is held to be the more suitable abstraction: "World models offer a compelling alternative: by predicting the outcomes of candidate action sequences, they enable online planning through counterfactual reasoning." But training an action-conditioned robotic world model directly in the real world requires diverse data at an unrealistic scale — "training action-conditioned robotic world models directly in the real world requires diverse data at impractical scale."

"world models, rather than monolithic end-to-end policies, provide the right abstraction for leveraging prior experience to improve efficiently in new environments."

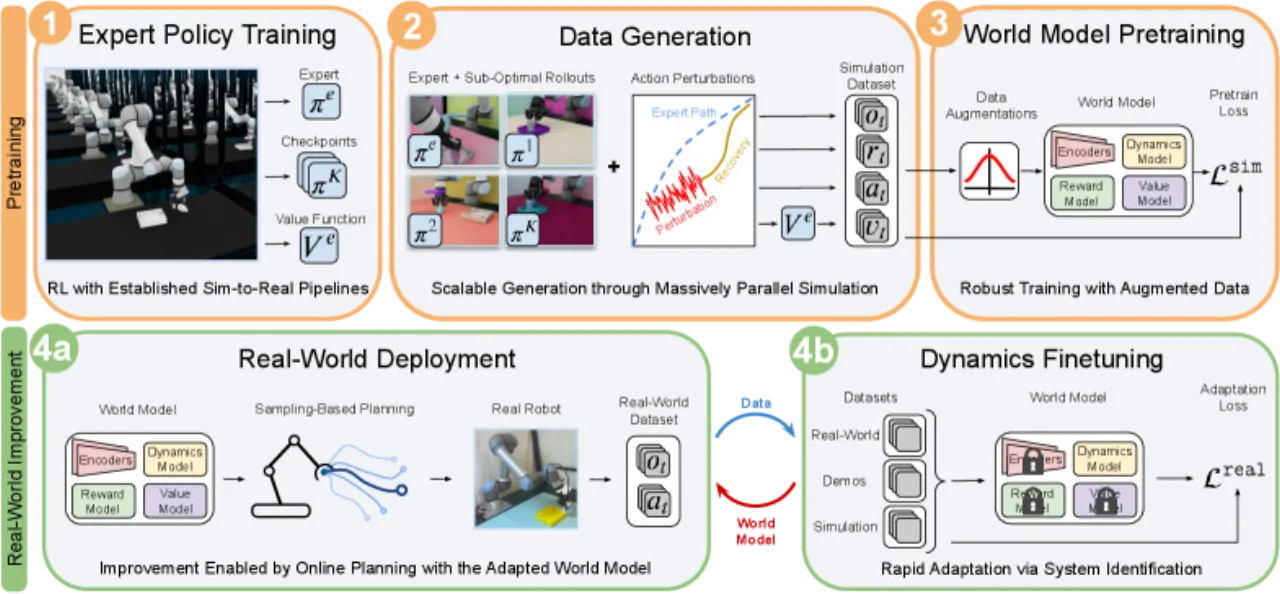

SimDist overview
Figure 2(论文原图):SimDist overview。1) 在仿真中用特权状态(privileged state)训练专家策略、策略 checkpoint 序列和价值函数;2) 混合专家策略与次优策略、并周期性注入随机动作扰动,生成覆盖广泛失败/恢复模式的大规模训练数据,用于预训练世界模型;真实世界部署阶段只更新 latent dynamics 模型。Figure 2 (from the paper): SimDist overview. 1) In simulation, privileged state is used to train an expert policy, a sequence of policy checkpoints and a value function; 2) alternating the expert policy with sub-optimal policies and periodically injecting random action perturbations produces large-scale training data covering a wide range of failure/recovery modes, used to pretrain the world model; during real-world deployment only the latent dynamics model is updated.
~2×SimDist 在各任务上普遍达到基线约 2 倍的分数("typically reaches scores around 2× higher than any baseline")Across tasks SimDist generally reaches about 2× the score of the baselines ("typically reaches scores around 2× higher than any baseline")
100M / 100k四足 / 操作任务的仿真预训练轨迹规模Scale of simulation pretraining trajectories for the quadruped / manipulation tasks
15–35.7 分钟15–35.7 minutes真实世界自适应所用数据量(操作 15–30 min;四足 32.1–35.7 min)Amount of data used for real-world adaptation (manipulation 15–30 min; quadruped 32.1–35.7 min)
1.5×–2×训练中吞吐量(success/min)相对 zero-shot 的提升幅度Gain in training throughput (success/min) relative to zero-shot

02 Method

SimDist 分两个阶段:仿真预训练阶段用特权状态训练的专家策略 + 次优策略 + 随机动作扰动,生成覆盖失败与恢复行为的多样化轨迹,联合训练 latent dynamics、reward、value 与 behavior-cloning 四个损失项;真实世界自适应阶段冻结编码器、奖励模型与价值函数,只用真实世界的预测误差更新 latent dynamics 模型,将适应问题化简为监督式系统辨识,同时保留稠密、长时程的规划信号供在线改进使用。SimDist has two stages. In the simulation pretraining stage, an expert policy trained on privileged state + sub-optimal policies + random action perturbations generate diverse trajectories covering failure and recovery behaviour, and the four loss terms latent dynamics, reward, value and behavior cloning are trained jointly; in the real-world adaptation stage the encoder, reward model and value function are frozen and only the latent dynamics model is updated from real-world prediction error, reducing the adaptation problem to supervised system identification while preserving dense, long-horizon planning signals for online improvement.

World model architecture

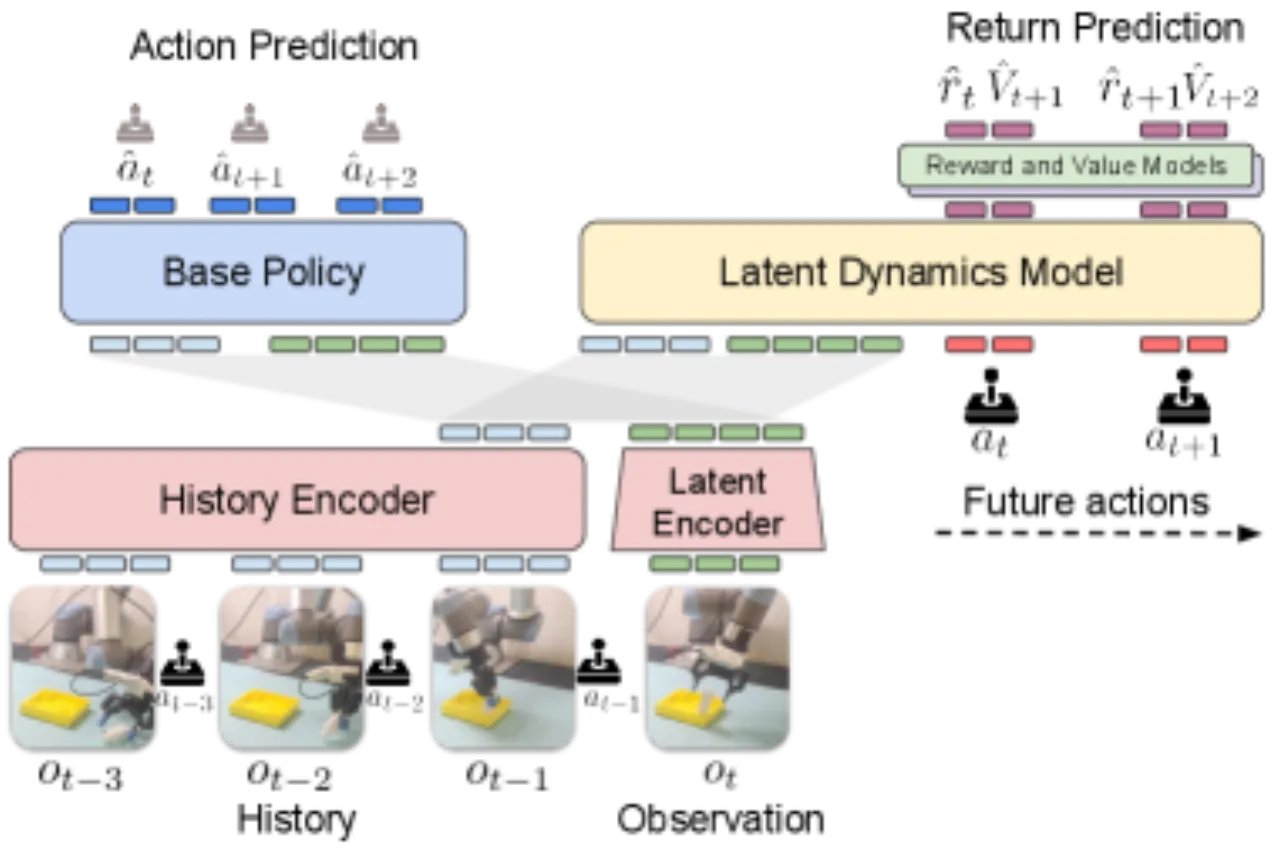

Figure 3(论文原图):World model architecture。最新观测被编码为 latent 表示,history encoder 处理观测-动作历史,二者联合条件化一个基于 transformer 的 latent dynamics 模型,在单次前向传播中预测候选动作序列下的未来 latent 轨迹;transformer 化的 reward/value 模型对预测轨迹做 attention 以估计回报。Figure 3 (from the paper): World model architecture. The latest observation is encoded into a latent representation and a history encoder processes the observation-action history; jointly they condition a transformer-based latent dynamics model that predicts, in a single forward pass, the future latent trajectory under a candidate action sequence. A transformer reward/value model attends over the predicted trajectory to estimate the return.

仿真中的多样化数据生成(Diverse Data Generation)Diverse Data Generation in Simulation

论文强调:规划器会主动搜索高价值动作序列,并在覆盖薄弱处利用模型误差,因此模型必须在专家分布与真实数据分布之外仍然可靠。为此,SimDist 通过"alternating between an expert policy and a set of sub-optimal policies, and by periodically injecting random action perturbations over short temporal windows"来生成多样化 rollout,从而覆盖专家流形之外的失败与恢复行为。预训练损失同时监督 latent dynamics、reward、value 和 behavior cloning 四项:The paper stresses that the planner actively searches for high-value action sequences and exploits model error wherever coverage is thin, so the model must remain reliable outside the expert distribution and the real data distribution. SimDist therefore generates diverse rollouts by "alternating between an expert policy and a set of sub-optimal policies, and by periodically injecting random action perturbations over short temporal windows", covering failure and recovery behaviour off the expert manifold. The pretraining loss supervises latent dynamics, reward, value and behavior cloning at the same time:

tsim(θ) 由 latent-dynamics 项 ‖ẑt+i+1 − sg(Eθ(ot+i+1))‖²、reward 项 c₁(r̂t+i−rt+i)²、value 项 c₂(v̂t+i+1−vt+i+1)² 以及仅对专家动作生效的 behavior-cloning 项 c₃·𝟙e(at+i)‖ât+i−at+i‖² 组成(原文 Eq. 2)。tsim(θ) consists of a latent-dynamics term ‖ẑt+i+1 − sg(Eθ(ot+i+1))‖², a reward term c₁(r̂t+i−rt+i)², a value term c₂(v̂t+i+1−vt+i+1)², and a behavior-cloning term that applies only to expert actions, c₃·𝟙e(at+i)‖ât+i−at+i‖² (Eq. 2 in the paper).

真实世界自适应 = 系统辨识(System Identification)Real-World Adaptation = System Identification

部署阶段,SimDist "freezes the encoder, reward model, and value function learned in simulation, and updates only the latent dynamics model using real-world prediction losses"。这一设计"reduces adaptation to supervised system identification while preserving dense, long-horizon planning signals for online improvement"——即真实世界只需纠正仿真与现实之间的动力学差距,而不必重新学习奖励和价值判断。At deployment SimDist "freezes the encoder, reward model, and value function learned in simulation, and updates only the latent dynamics model using real-world prediction losses". This design "reduces adaptation to supervised system identification while preserving dense, long-horizon planning signals for online improvement" — that is, the real world only has to correct the dynamics gap between simulation and reality, without relearning reward and value judgements.

基于 MPPI 的在线规划MPPI-Based Online Planning

使用 Model Predictive Path Integral (MPPI)——一种基于采样的 MPC 方法——评估候选动作序列:reward/value 模型对整条预测 latent 轨迹 ẑt:t+T 做 attention,从而得到更准确的回报估计,再据此挑选并执行动作。Model Predictive Path Integral (MPPI) — a sampling-based MPC method — is used to evaluate candidate action sequences: the reward/value model attends over the entire predicted latent trajectory ẑt:t+T to obtain a more accurate return estimate, and the action is then selected and executed accordingly.

03 Experiments

操作任务在 UR5e 机械臂上进行:Peg Insertion(16 mm 方形插销任务)与 Table Leg(桌腿插孔装配),初始条件分别取自 Narrow / Wide 网格;仿真预训练用 100k 条轨迹。四足任务在 Unitree Go2 上进行:Slippery Slope(3.0°/5.7° 覆盖 PTFE 的低摩擦斜坡,需走完 1.82 m)与 Foam(两块 5 cm 厚记忆棉,仿真中未建模其柔顺动力学,需走完 3.00 m);仿真预训练用 100M 条轨迹。对照基线为使用相同编码器、但策略头为 MLP 的 state-of-the-art 在线 RL 方法(IQL、RLPD 等),操作任务上另加行为克隆基线;真实世界微调数据量为操作任务 15–30 分钟,四足 Slippery Slope 35.7 分钟、Foam 32.1 分钟。The manipulation tasks run on a UR5e arm: Peg Insertion (a 16 mm square peg) and Table Leg (assembling a table leg into its hole), with initial conditions drawn from a Narrow / Wide grid respectively; simulation pretraining uses 100k trajectories. The quadruped tasks run on a Unitree Go2: Slippery Slope (a 3.0°/5.7° low-friction slope covered with PTFE, 1.82 m to be traversed) and Foam (two 5 cm thick memory-foam blocks whose compliant dynamics are not modelled in simulation, 3.00 m to be traversed); simulation pretraining uses 100M trajectories. The baselines are state-of-the-art online RL methods (IQL, RLPD, etc.) that use the same encoder but an MLP policy head, plus a behavior cloning baseline on the manipulation tasks; real-world finetuning data amounts to 15–30 minutes for manipulation, 35.7 minutes for quadruped Slippery Slope and 32.1 minutes for Foam.

整体结果(Fig. 4,定性):"Across all tasks, SimDist consistently outperforms prior approaches, achieving substantially higher success rates with far greater sample efficiency than online RL baselines, while autonomously improving well beyond the performance of behavior cloning methods... Across the board SimDist typically reaches scores around 2× higher than any baseline." 标准 RL 微调方法常出现灾难性遗忘(catastrophic forgetting),性能在适应过程中崩溃;SGFT(迁移仿真价值函数的基线)虽避免了崩溃,但采样效率仍显著低于 SimDist。此外,为 SimDist 额外提供示教数据只会进一步提升表现,说明它能自然吸收异质、混合质量的数据来源。Overall results (Fig. 4, qualitative): "Across all tasks, SimDist consistently outperforms prior approaches, achieving substantially higher success rates with far greater sample efficiency than online RL baselines, while autonomously improving well beyond the performance of behavior cloning methods... Across the board SimDist typically reaches scores around 2× higher than any baseline." Standard RL finetuning methods frequently show catastrophic forgetting, with performance collapsing during adaptation; SGFT (a baseline that transfers the simulation value function) avoids the collapse but is still markedly less sample-efficient than SimDist. Moreover, supplying SimDist with additional demonstration data only improves it further, showing that it naturally absorbs heterogeneous, mixed-quality data sources.

Manipulation success-rate curves
Figure 4 上半(论文原图):两个操作任务的 success rate(20 次试验统计),随真实世界微调数据量变化的曲线。Figure 4, top (from the paper): success rate on the two manipulation tasks (over 20 trials) as a function of the amount of real-world finetuning data.
Quadruped forward-progress curves

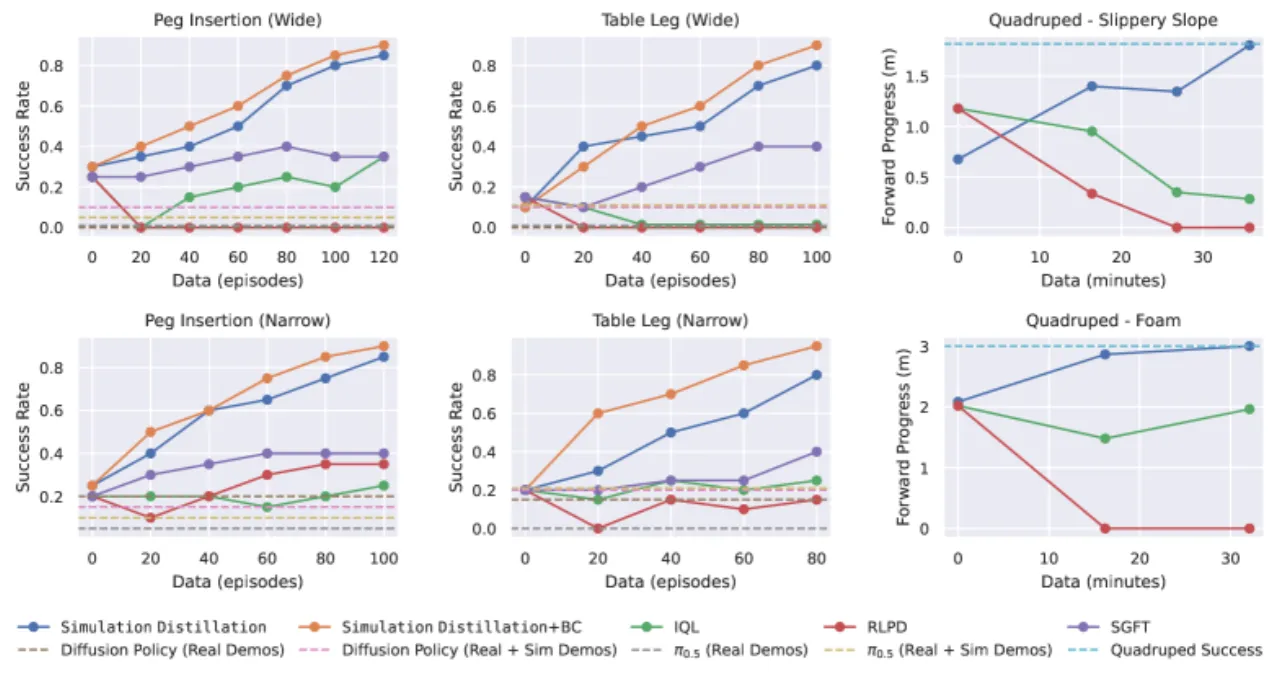

Figure 4 下半(论文原图):两个四足越障任务的平均 forward progress(15 次试验:3 种速度 × 5 次),随真实世界微调数据量变化的曲线。Figure 4, bottom (from the paper): average forward progress on the two quadruped traversal tasks (15 trials: 3 speeds × 5 runs) as a function of the amount of real-world finetuning data.

Table IX:四足真实世界结果(success / 5 次试验)Table IX: quadruped real-world results (success / 5 trials)

任务Task速度 (m/s)Speed (m/s)Pretrained (zero-shot)Single-step BCSimDist (ours)IQLRLPD
Slippery Slope0.10/52/54/50/50/5
Slippery Slope0.30/51/55/50/50/5
Slippery Slope0.50/50/55/50/50/5
Foam0.23/51/55/51/5
Foam0.72/51/55/52/5
Foam1.20/52/55/53/5

数据取自论文 Table IX;SimDist/IQL/RLPD 结果均为使用 35.7 分钟(Slippery Slope)/ 32.1 分钟(Foam)真实数据微调后的表现。"RLPD results on the Foam task are not reported, as the method destabilized the robot prior to evaluation."Data taken from Table IX of the paper; the SimDist/IQL/RLPD results are all after finetuning on 35.7 minutes (Slippery Slope) / 32.1 minutes (Foam) of real data. "RLPD results on the Foam task are not reported, as the method destabilized the robot prior to evaluation."

Ablations

Unfreezing world-model components(Fig. 10):"Unfreezing the encoder causes complete performance loss, as frozen reward and value heads receive latents outside their training distribution. Unfreezing the value function... reintroduces long-horizon credit assignment from limited real-world data and causes catastrophic forgetting." 换言之,只冻结 dynamics 之外的一切、且只微调 dynamics 是关键设计,而非可有可无的选择。Unfreezing world-model components (Fig. 10): "Unfreezing the encoder causes complete performance loss, as frozen reward and value heads receive latents outside their training distribution. Unfreezing the value function... reintroduces long-horizon credit assignment from limited real-world data and causes catastrophic forgetting." In other words, freezing everything except the dynamics and finetuning the dynamics alone is a critical design choice, not an optional one.

Ablation: unfreezing world-model components

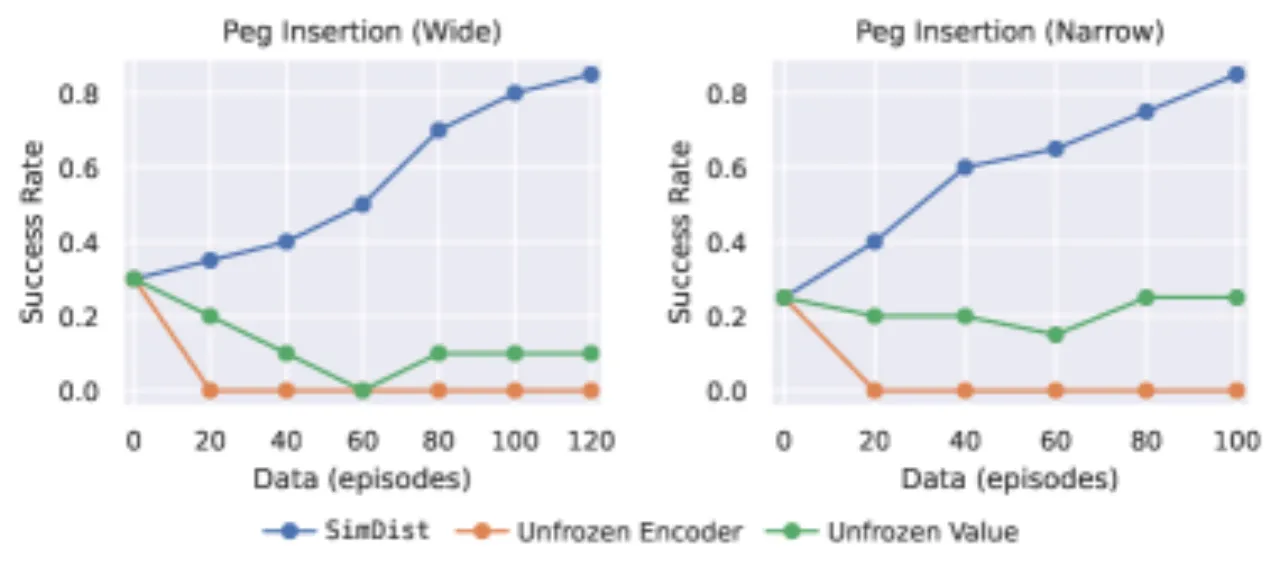

Figure 10(论文原图):真实世界自适应阶段解冻不同世界模型组件的消融实验——只解冻 latent dynamics(SimDist 的默认做法)表现最好,解冻 encoder 或 value function 都会显著损害性能甚至彻底失效。Figure 10 (from the paper): ablation on unfreezing different world-model components during real-world adaptation — unfreezing only the latent dynamics (SimDist's default) performs best, while unfreezing the encoder or the value function markedly hurts performance or fails outright.

此外论文还报告:解冻策略在数据规模消融(Table I,10%/50% 仿真数据)中验证了大规模、多样化仿真数据对性能的贡献;Fig. 6 显示 SimDist 训练吞吐量(success/min)"monotonically improves throughput by ∼1.5×–2× over zero-shot performance";Fig. 7 的散点图显示,相比 Diffusion Policy,SimDist 在 Peg Wide 任务上学到的策略对初始条件的鲁棒性明显更强,体现了大规模仿真预训练带来的状态空间覆盖优势。The paper further reports: the data-scale ablation (Table I, 10%/50% of the simulation data) confirms the contribution of large-scale, diverse simulation data to performance; Fig. 6 shows that SimDist training throughput (success/min) "monotonically improves throughput by ∼1.5×–2× over zero-shot performance"; and the scatter plot in Fig. 7 shows that, compared with Diffusion Policy, the policy SimDist learns on the Peg Wide task is markedly more robust to initial conditions, reflecting the state-space coverage that large-scale simulation pretraining brings.

04 Limitations

Note: 论文没有单独的 "Limitations" 小节,以下三点均明确写在 Conclusion 中(stated),逐字引用;未做任何推测性补充。The paper has no separate "Limitations" section; all three points below are explicitly stated in the Conclusion and are quoted verbatim, with no speculative additions.
冻结的 reward / value 模型可能成为性能天花板(stated)Frozen reward / value models may cap performance (stated)

"freezing reward and value models can cap performance when the transferred value function saturates or no longer distinguishes high-performing real-world trajectories. Closing the gap to near-perfect success may require selectively updating value functions in addition to dynamics."

不训练互联网规模视频数据,感知模态也较受限(stated)No training on internet-scale video, and sensing modalities are limited (stated)

"SimDist also does not train on internet-scale video or richer sensing modalities..."

性能依赖仿真覆盖的广度(stated)Performance depends on the breadth of simulation coverage (stated)

"...and still depends on simulation coverage broad enough to support reliable planning." 即如果仿真器无法覆盖真实世界会遇到的状态-动作分布,规划质量会受限。That is, if the simulator cannot cover the state-action distribution that will be encountered in the real world, planning quality is limited.
